ℹ️
This walkthrough covers the Inspection type (checklist-based, US-style), using the ASME A17.1 standard as an example. If your organization uses Audit inspections, see the Audit Walkthrough. Click any screenshot to enlarge it.
1. Create Project
2. Schedule
3. Start
4. Select Unit
5. Building & Unit
6. Checklist
7. Sign-Off
8. Review
9. Submit
Step 1 Create Project

The inspection process begins with creating a project in the Project Management section. A project ties together the client, building, site, inspection type, and work order details.

Navigate to Project Management β†’ + Create Project and fill in all required fields: client, project name, building, site, inspection type, and work order received date.

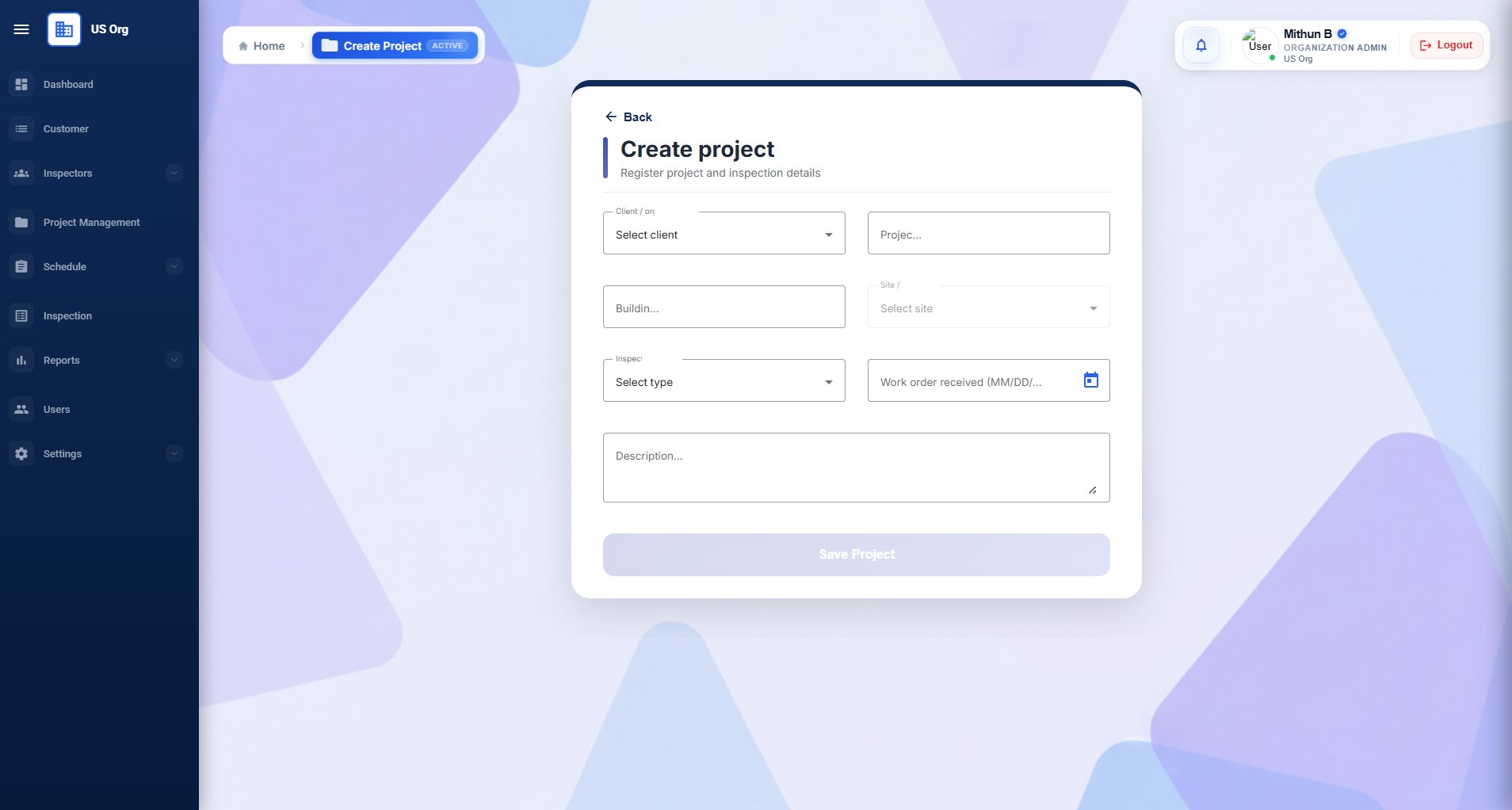

Create Project form
Create Project form with client, project name, building, site, inspection type, and work order date fields
Fill in the Client, Project Name, Building, Site, Inspection Type, and Work Order Received date. Click Save Project when complete.

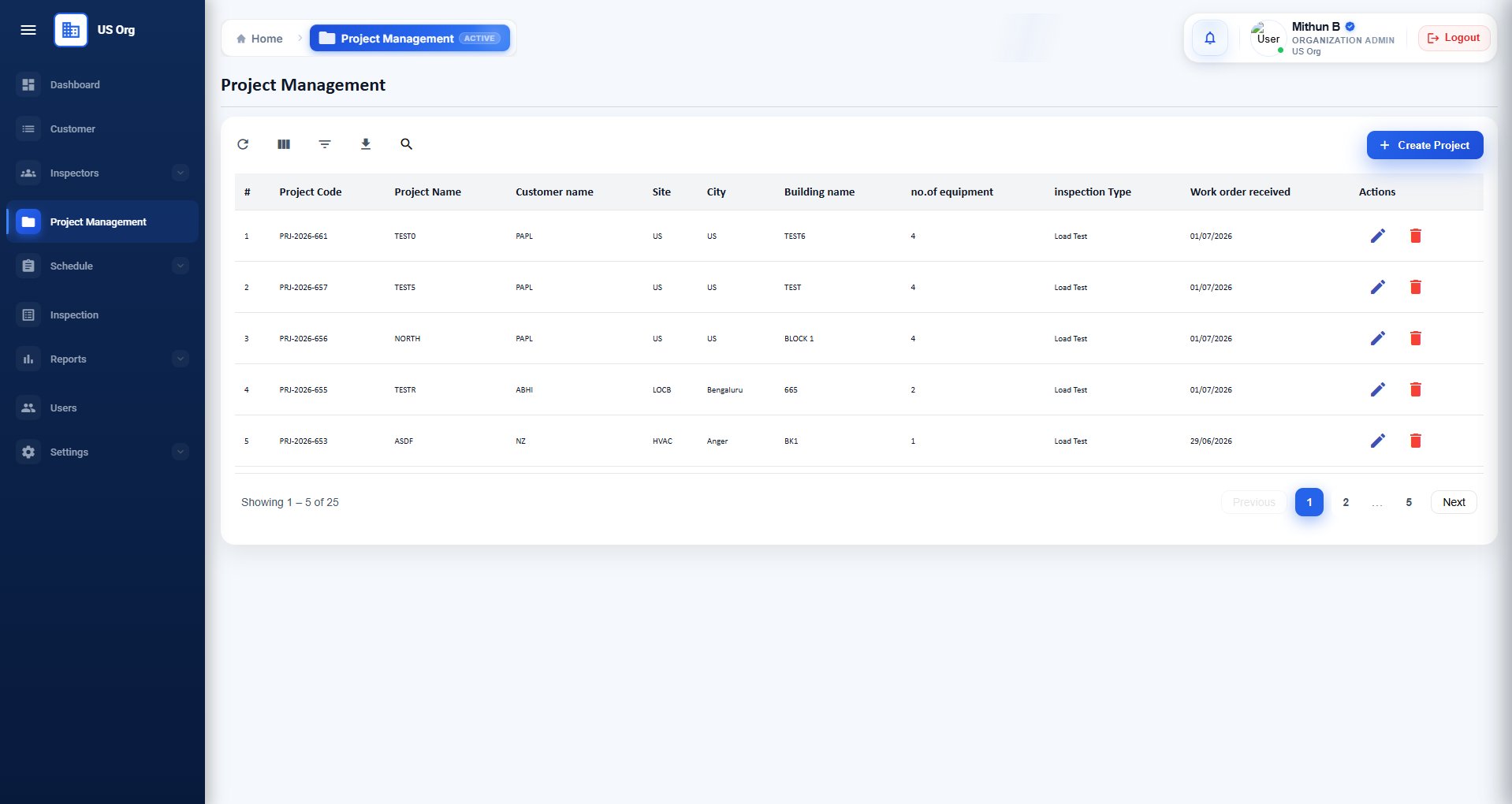

Project Management list
Project Management list showing all projects with codes, names, clients, and inspection types
Once saved, the project appears in the Project Management list with its assigned project code (e.g. PRJ-2026-661). You can edit or delete projects from the Actions column.
Step 2 Schedule the Inspection

Once the project is created, schedule the inspection by assigning an inspector and selecting a date and time slot from the availability calendar.

Go to Schedule β†’ Schedule Inspection, select the project, choose the inspector type, and pick an available slot on the calendar.

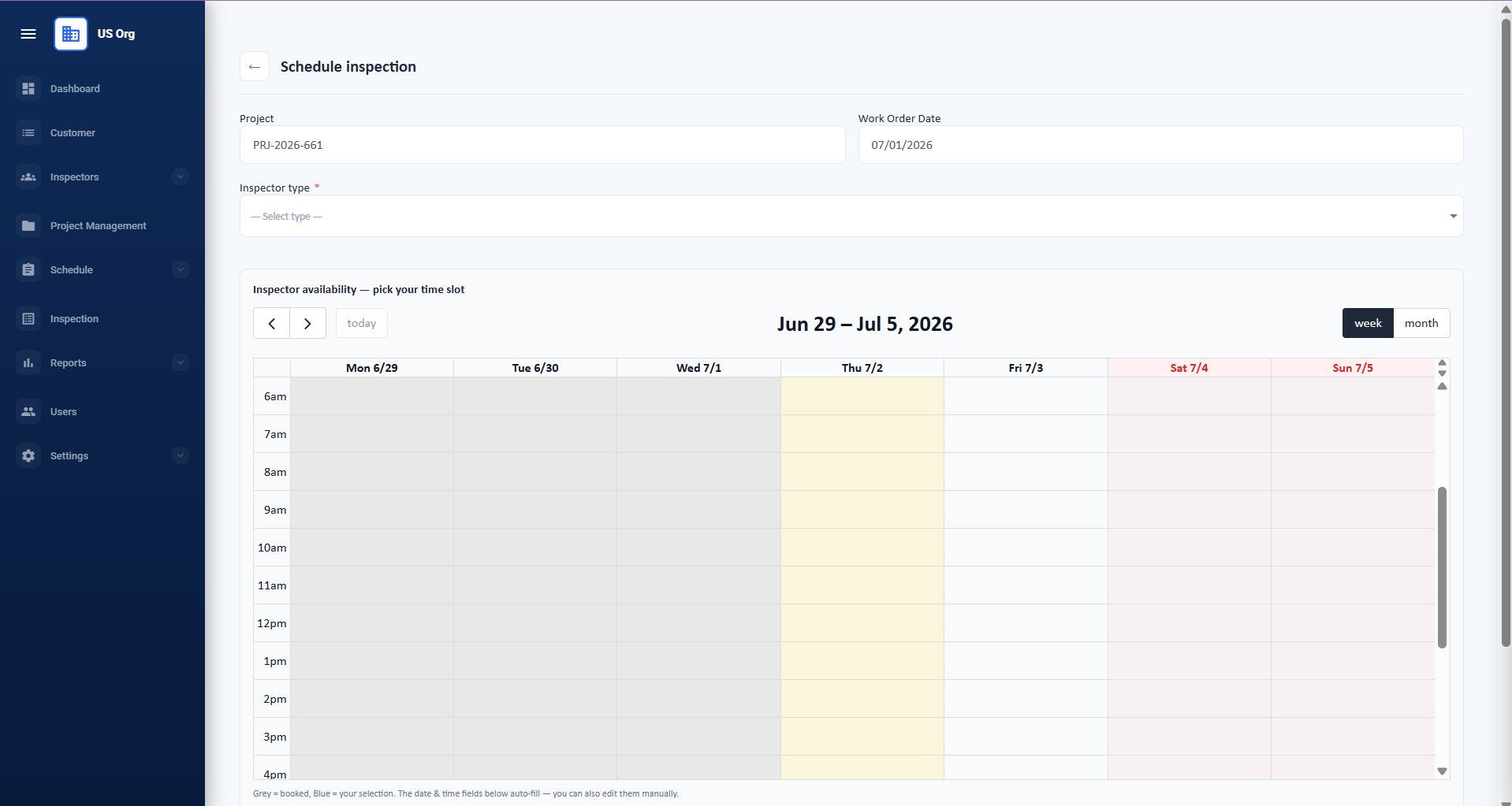

Schedule Inspection β€” calendar view
Schedule inspection screen showing project, work order date, inspector type selector, and weekly calendar
Select the Project and Inspector Type. The calendar shows weekly availability β€” grey slots are already booked. Click any open slot on the inspector's available day to select your time.

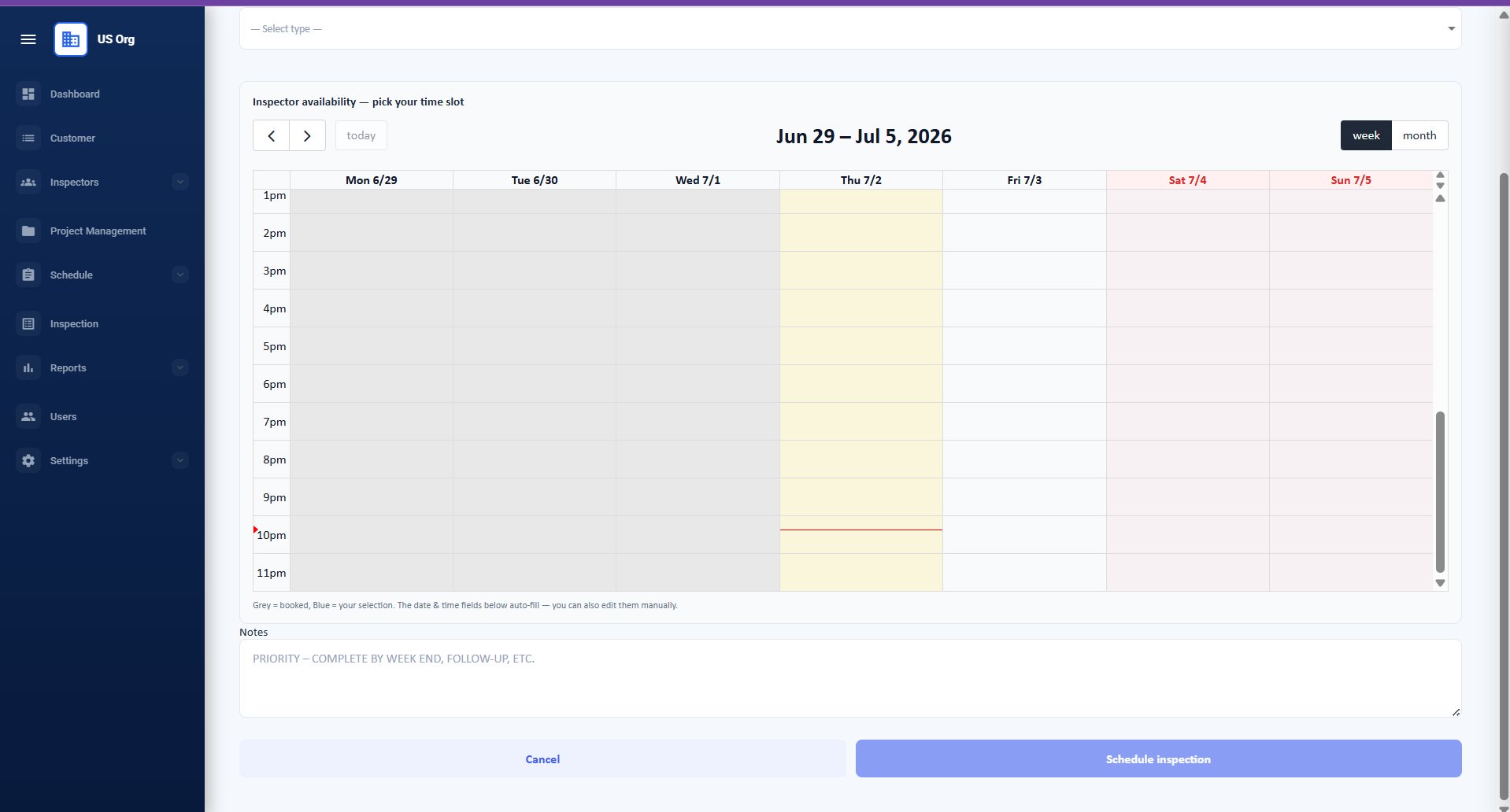

Confirm and schedule
Lower portion of schedule inspection screen showing notes field and Schedule Inspection button
Add any priority notes (e.g. "complete by week end") in the Notes field, then click Schedule Inspection to confirm the booking.
Step 3 Start the Inspection from Queue

On the day of the inspection, open the Inspection section to see your assigned inspections. Each entry shows the reference number, project code, mode (Onsite/Remote), steps completed, scheduled time, and current status.

Click Start next to your assigned inspection to begin.

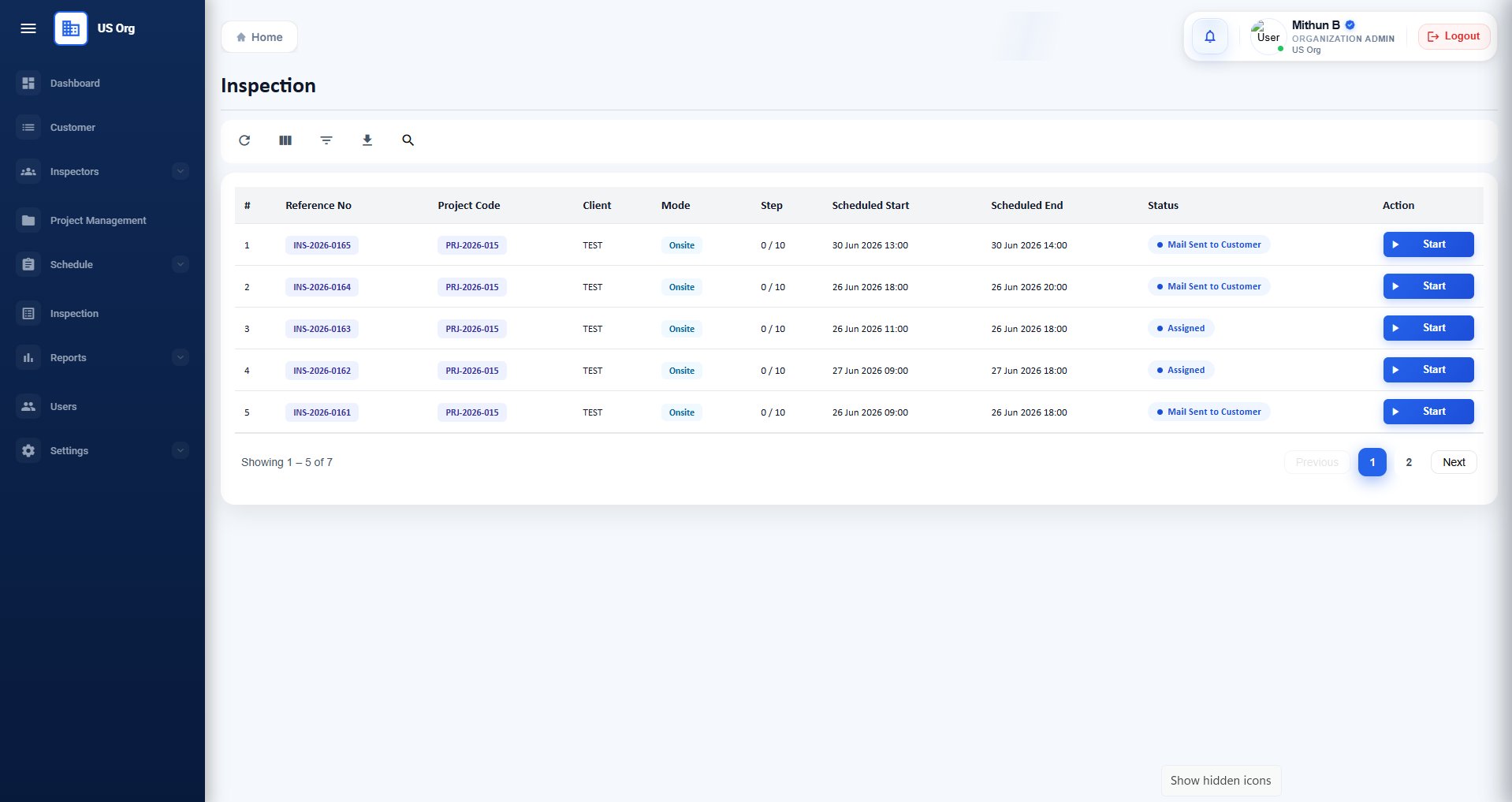

Inspection queue
Inspection queue showing list of assigned inspections with reference numbers, project codes, and Start buttons
Find your inspection by reference number or project code. The Status column shows where each inspection stands (Assigned, Mail Sent to Customer, etc.). Click Start to begin.
Step 4 Select a Unit

After starting the inspection, the Inspection Units screen shows all units (equipment) associated with the project. Each unit card displays the unit name, device type, location, checklist type, and current status.

Click Start Inspection (or Resume Inspection if continuing) on the unit you want to inspect.

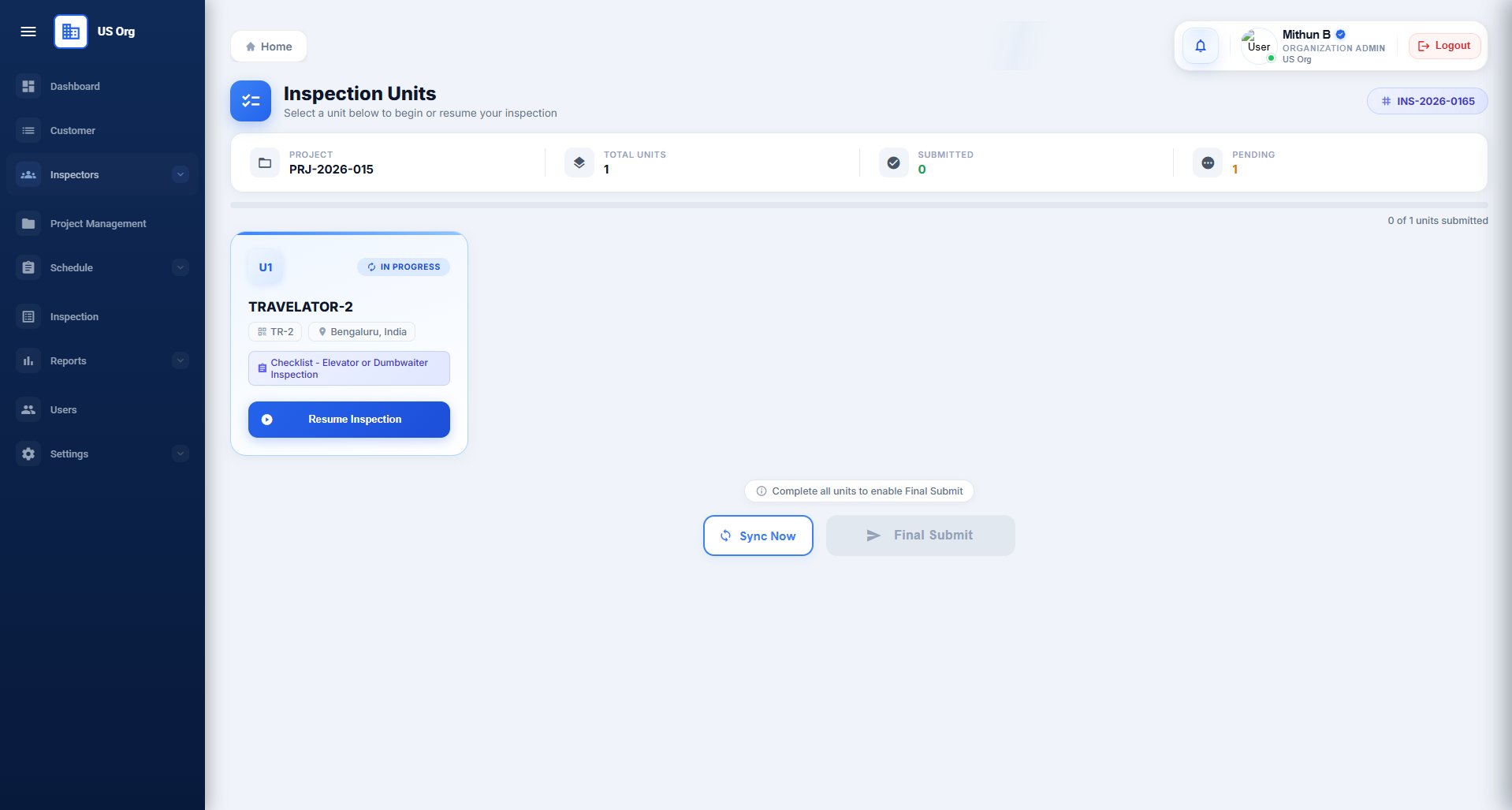

Inspection Units β€” select a unit
Inspection Units screen showing unit card with device name, checklist type, and Resume Inspection button
The unit card shows the device name, unit identifier, location, and the checklist type assigned (e.g. "Checklist - Elevator or Dumbwaiter Inspection"). A progress bar at the top tracks submitted vs. pending units.
Step 5 Building & Unit Details

Before the checklist begins, complete the Building & Unit Information form. This captures the physical details of the building and equipment that will appear on the final inspection report.

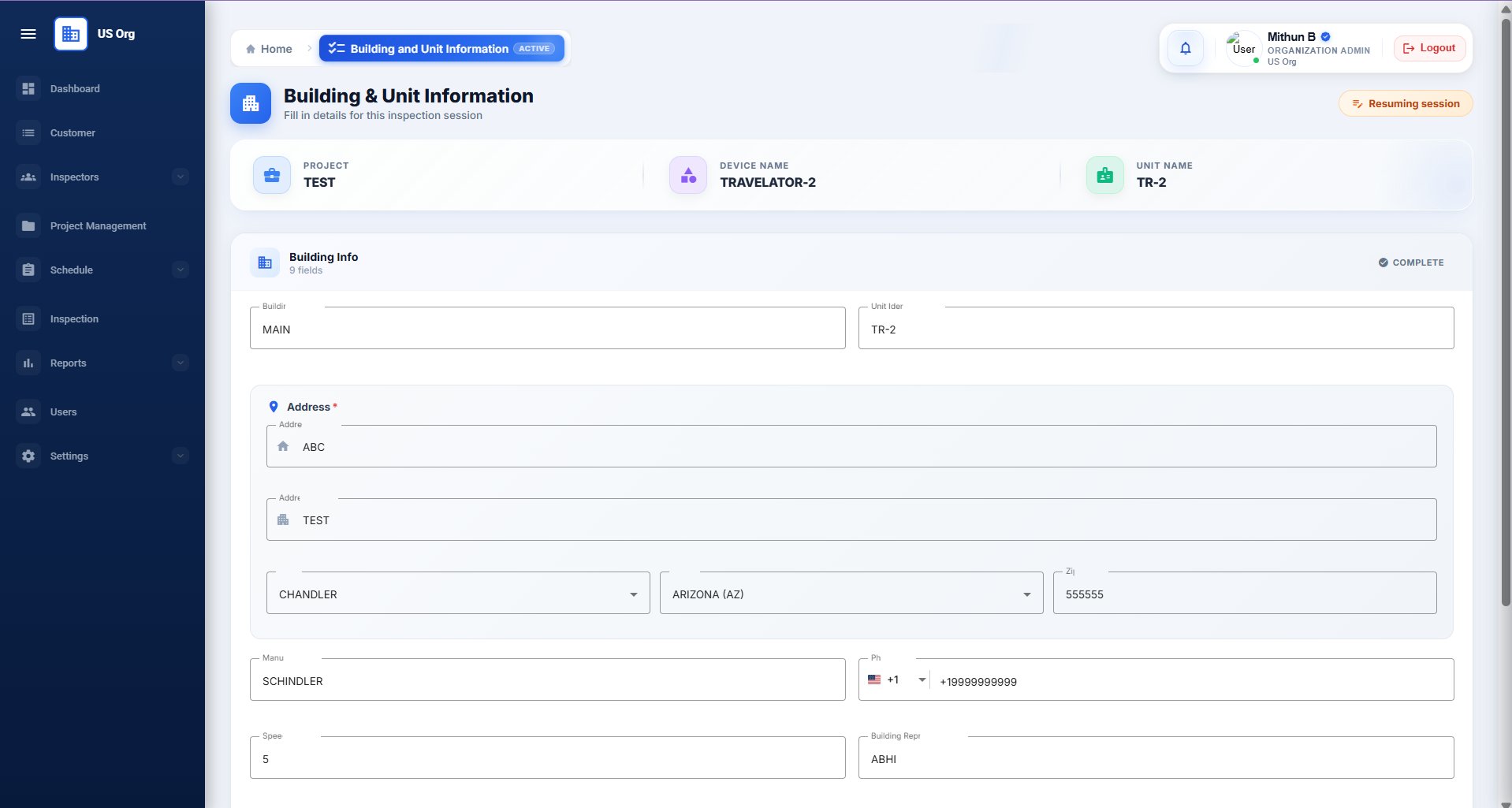

Building Info β€” top fields
Building and Unit Information form showing building name, unit identifier, address fields, manufacturer, and speed
Enter the Building Name, Unit Identifier, street address, city, state, zip code, Manufacturer, phone number, speed (FPM), and Building Representative name.

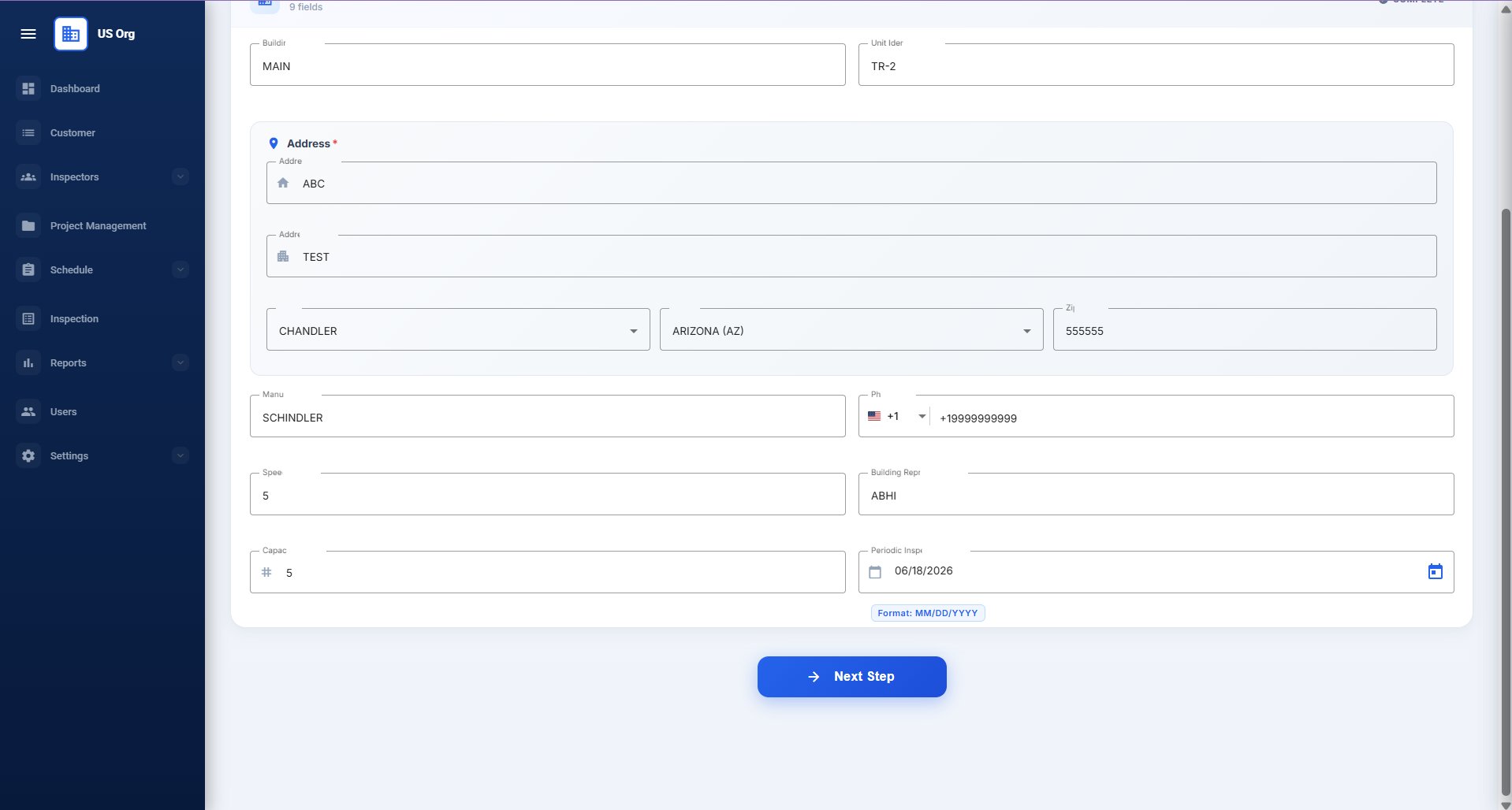

Building Info β€” capacity and periodic date
Lower portion of Building Info form showing capacity, periodic inspection date, and Next Step button
Enter the Capacity (lbs) and Periodic Inspection Date. Once all required fields are complete, click Next Step to proceed to the checklist.
Step 6 Complete the ASME A17.1 Checklist

The heart of the Inspection is the structured checklist. Each checklist is organized into tabbed sections (e.g. Elevator-Inside of Car, Machine Room, Top of Car, Outside Hoistway, Pit, Fire Service). Work through each tab and mark every item OK, NG (No Good), or NA (Not Applicable).

πŸ’‘
Use Select for All at the top right to batch-mark all items in the current tab as OK, NG, or NA. You can still override individual items after using this shortcut.

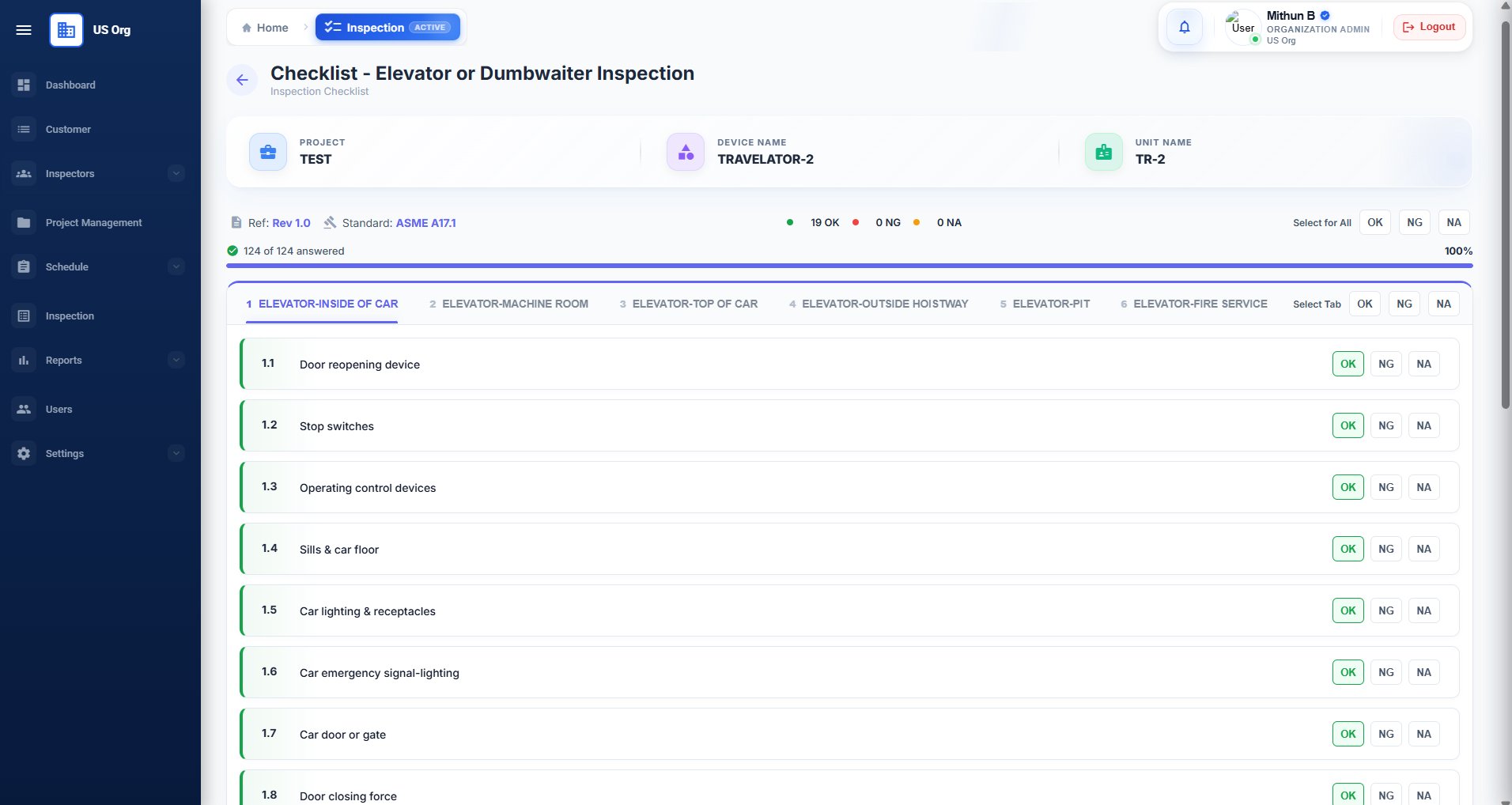

ASME A17.1 checklist β€” Elevator Inside of Car tab
Checklist for Elevator or Dumbwaiter Inspection showing tabbed sections and OK/NG/NA buttons per item
Each section is a tab at the top. The progress indicator shows items answered (e.g. 124 of 124 = 100%). Tap OK, NG, or NA for each numbered item. The green counter updates in real time.
Step 7 Inspector Sign-Off

After completing the checklist, the Inspector Sign-off screen collects your conclusions and credentials. Set the overall Inspection Result (Pass, Fail, or Permit Req'd), then complete the Inspector Information section with your certification details.

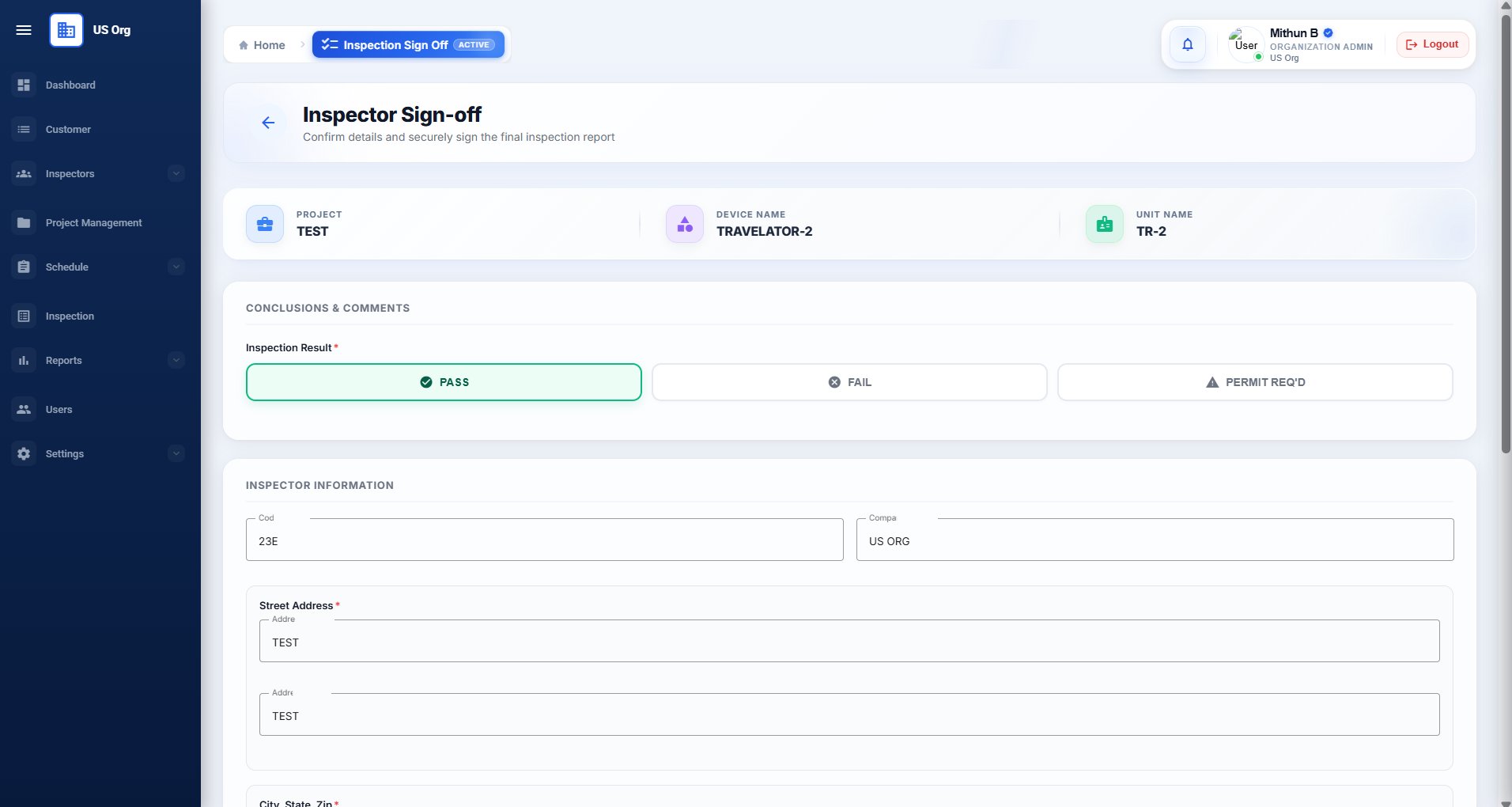

Inspector Sign-off β€” conclusions and inspector info
Inspector Sign-off screen showing Inspection Result buttons (Pass/Fail/Permit Req'd) and Inspector Information fields
Select the Inspection Result β€” PASS is pre-selected if all items are OK. Enter your Code Edition, Company Name, and Street Address in the Inspector Information section.

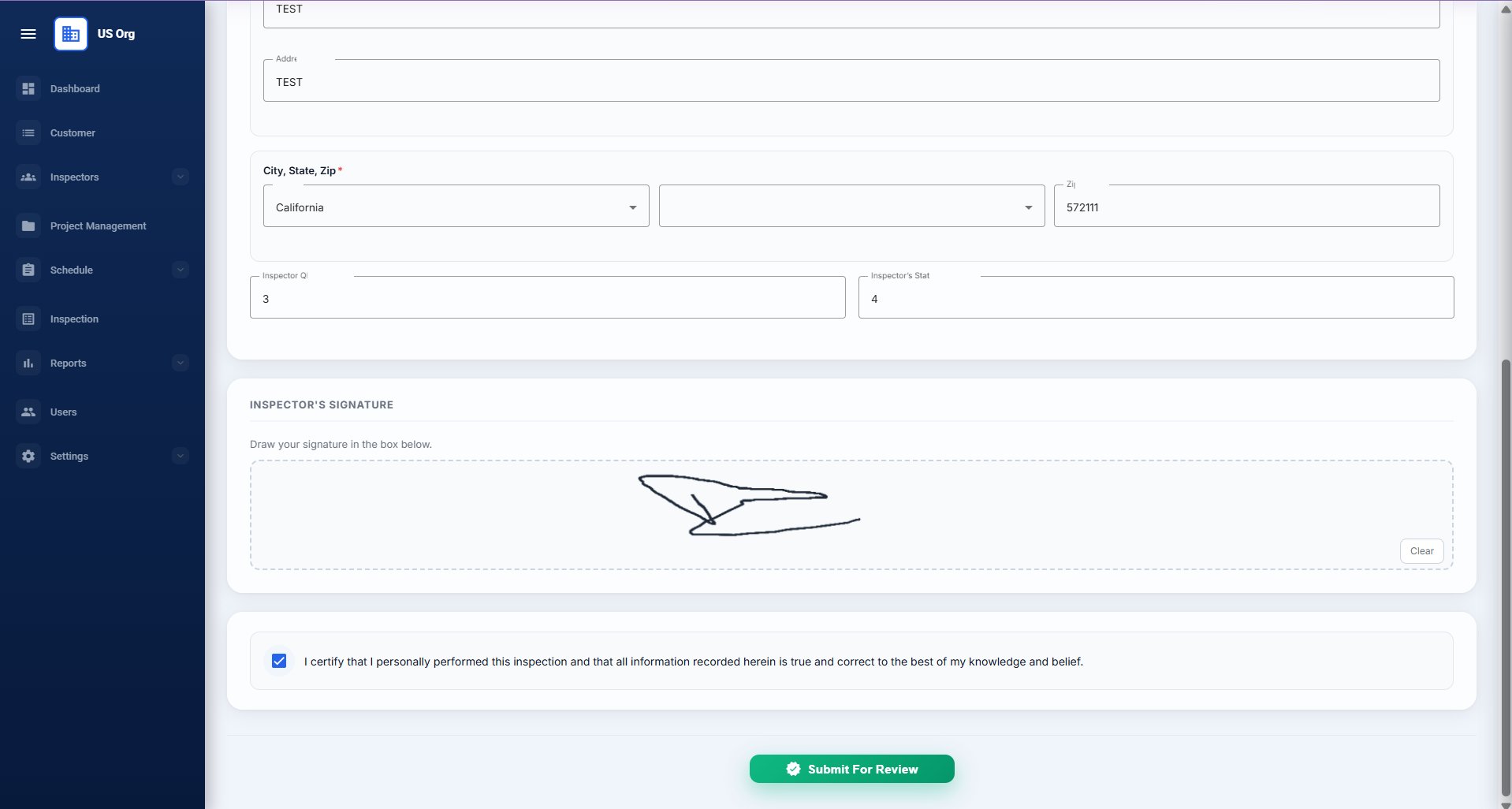

Inspector Sign-off β€” signature and certification
Lower portion of Inspector Sign-off showing City/State/Zip, QEI number, state license number, signature pad, certification checkbox, and Submit For Review button
Complete the City, State, Zip, Inspector QEI Number, and State License Number. Draw your signature in the signature box. Check the certification statement and click Submit For Review.
Step 8 Review the Inspection Report

Before final submission, review the Inspection Report Summary. This shows the Building & Unit Details and the full checklist results in a report format. Verify all information is correct before submitting.

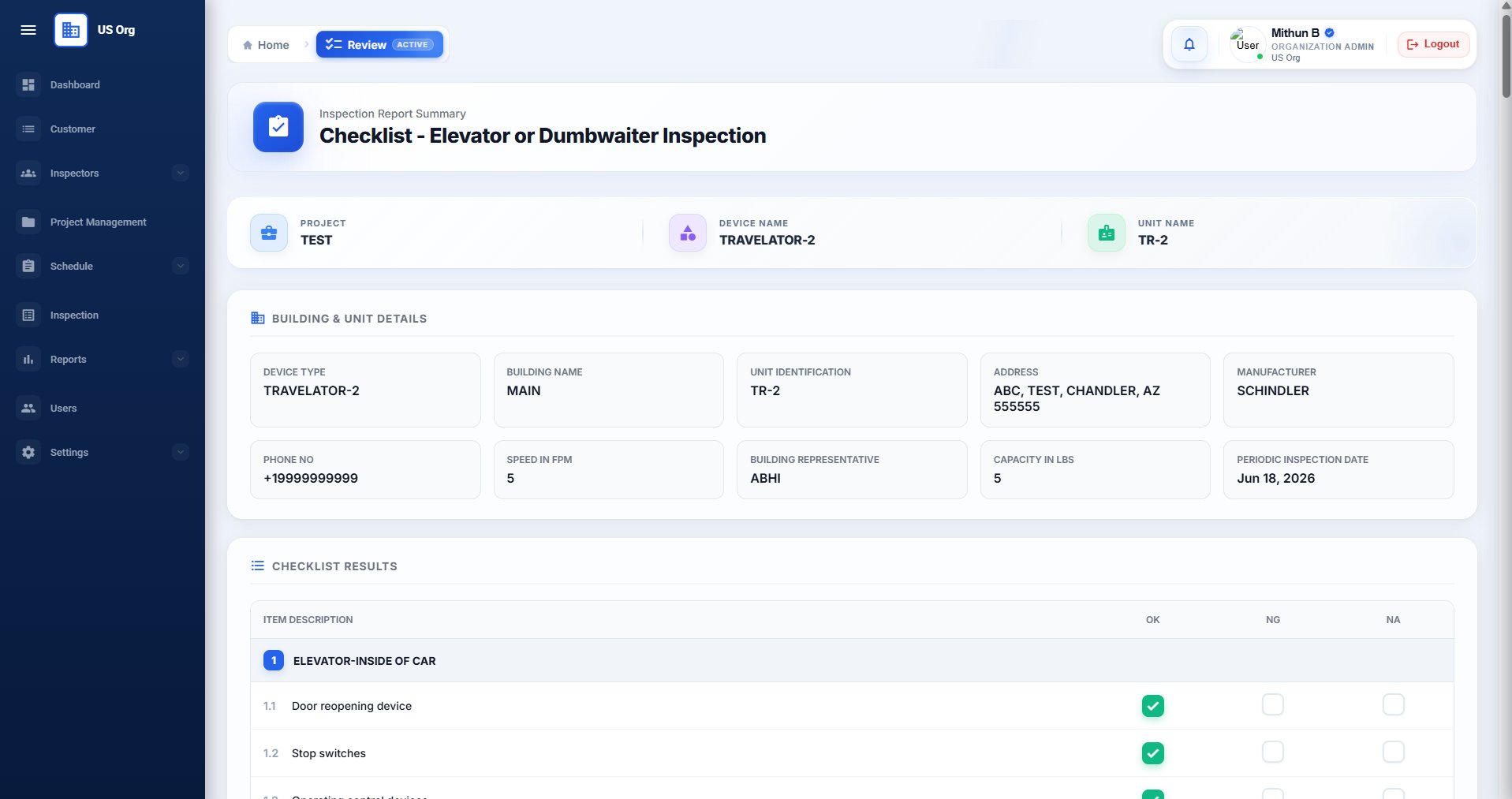

Inspection Report Summary β€” building details and checklist
Inspection Report Summary showing building and unit details panel and checklist results table with OK/NG/NA columns
Review the Building & Unit Details (device type, building name, address, manufacturer, speed, capacity, periodic date) and the Checklist Results section with OK/NG/NA status for every item.

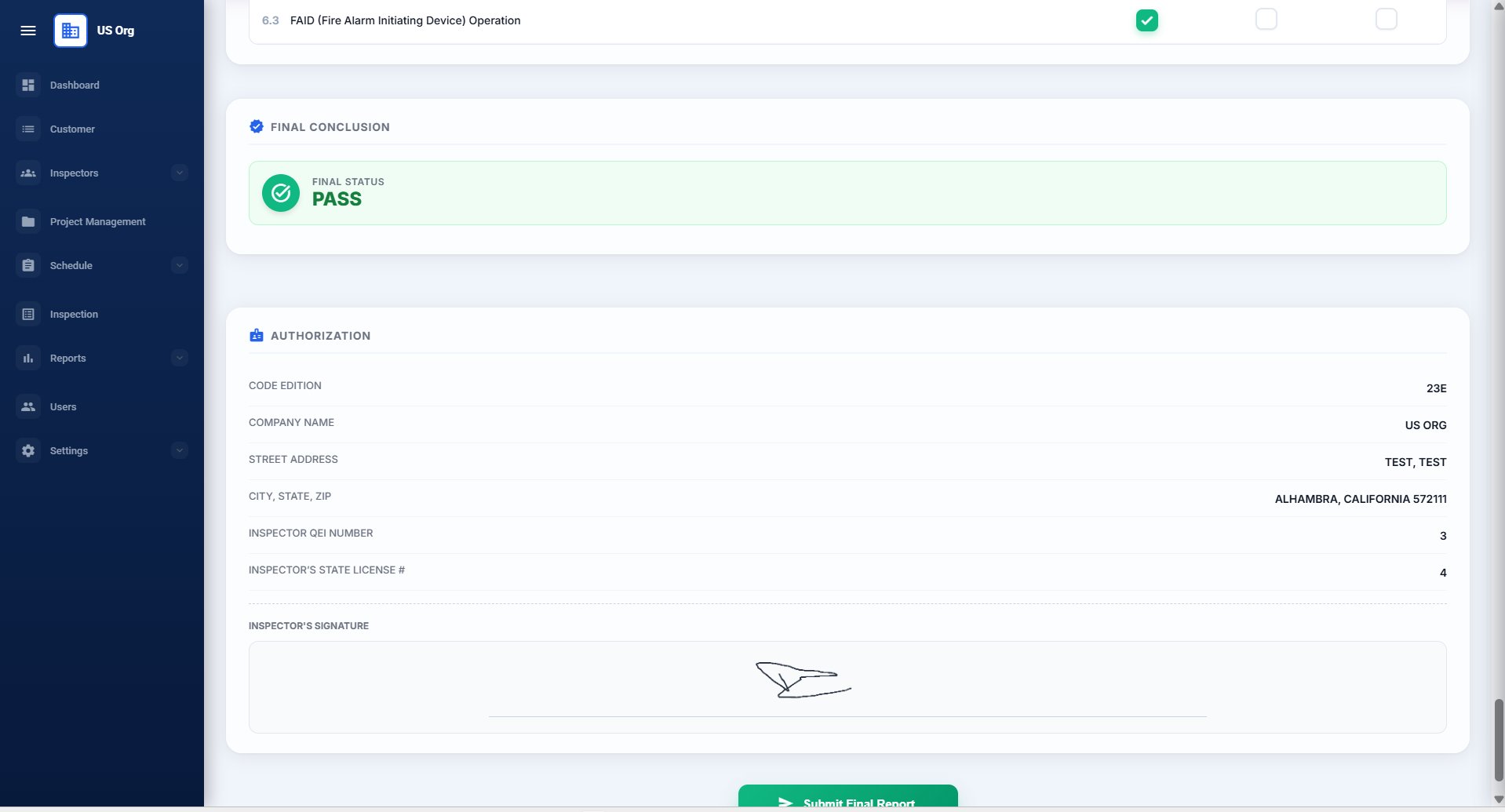

Final Conclusion and Authorization
Review screen showing Final Conclusion PASS status and Authorization section with inspector credentials and signature
Scroll to the bottom to see the Final Conclusion (PASS/FAIL) and the Authorization section with your credentials and signature. Click Submit Final Report once satisfied.
Step 9 Submit & Download Report

After submitting the unit, the Inspection Units screen updates to show the unit as Submitted. Once all units in the project are submitted, click Final Submit to complete the inspection. You can then download or view the official PDF report.

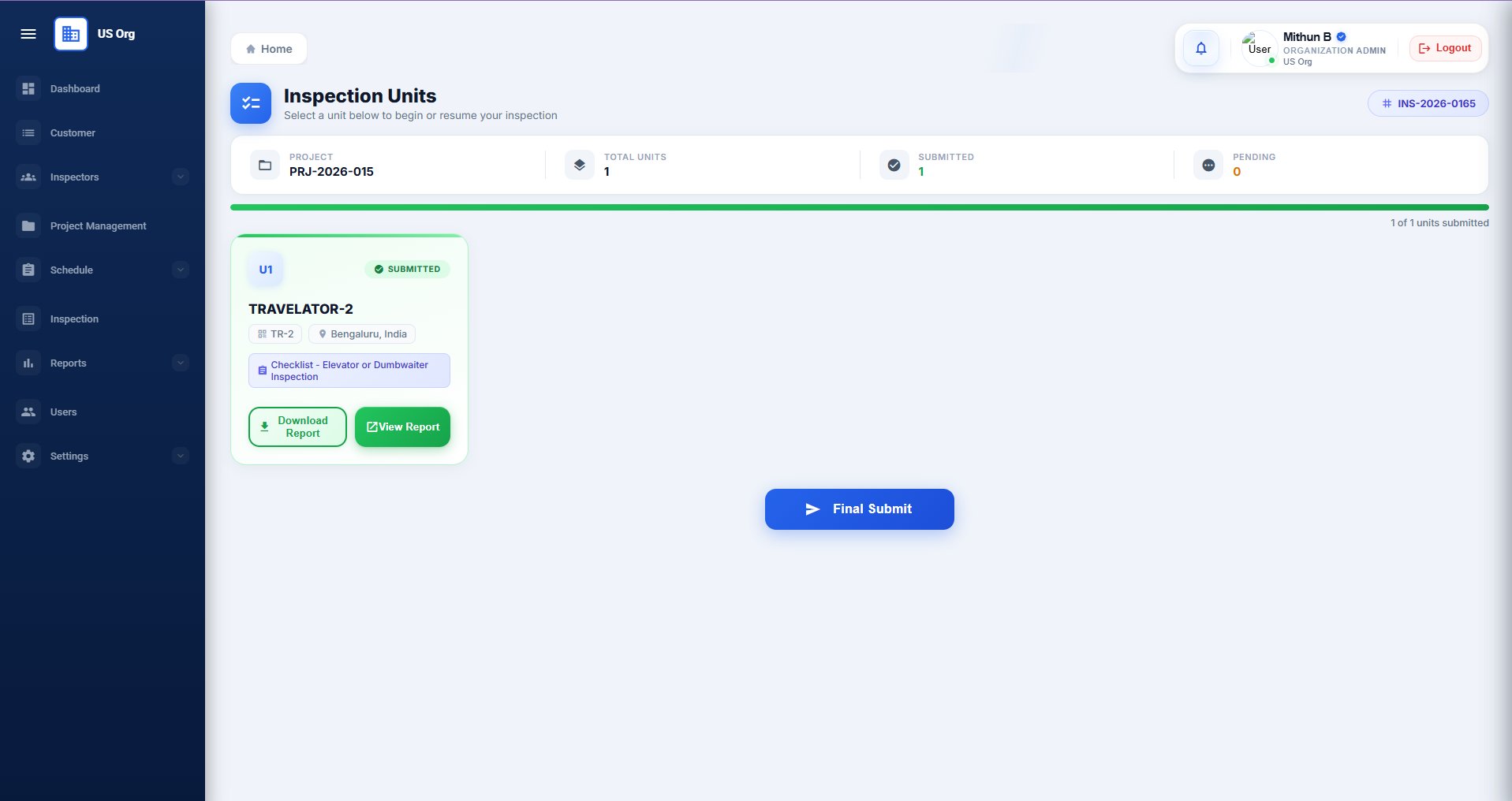

Inspection Units β€” unit submitted
Inspection Units screen showing unit card marked SUBMITTED with Download Report and View Report buttons
The unit card now shows SUBMITTED (green badge). The progress bar turns full green. Use Download Report or View Report to access the completed report. Click Final Submit to send to admin review.

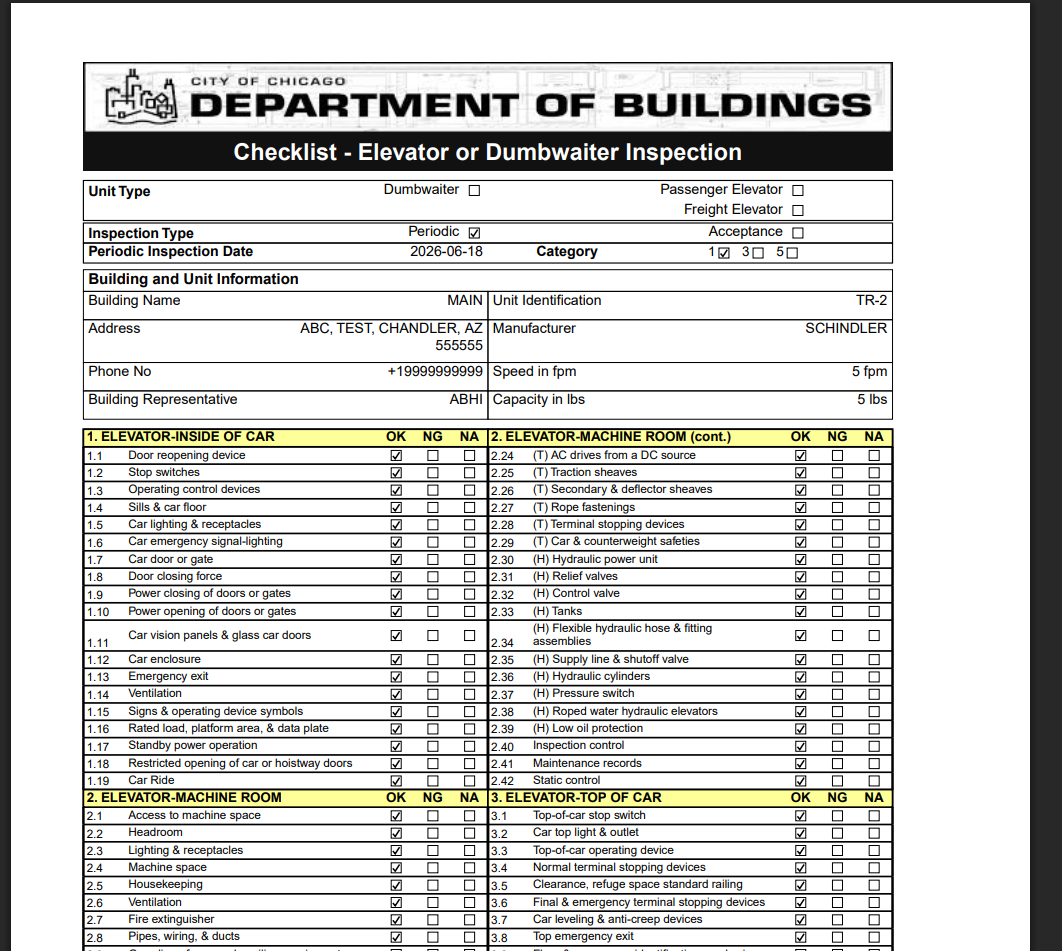

Final PDF report β€” City of Chicago Department of Buildings
PDF inspection report showing Department of Buildings header, checklist title, building details, and all checklist results in tabular format
The downloaded report is a formatted PDF containing the official inspection checklist, all building and unit details, your credentials, and your signature β€” ready for submission to the authority having jurisdiction (AHJ).
βœ…
The inspection is now complete. The report has been submitted for administrative review and the official PDF is available for download and submission to the relevant authority.
